Hinkley Point C & Sizewell C: Delivering Decarbonised Energy to Millions of Homes in the United Kingdom
General View of HPC, the Nuclear Island © EDF Energy
With the construction of these four EPR reactors (two units at each site), Framatome is supporting its customers in delivering low-carbon and energy-sovereign power in the United Kingdom.
On these two major industrial projects, Framatome is responsible for:
- The execution of nuclear island activities, from design and manufacturing through to installation and commissioning.
- The execution and supply of the plant’s safety and emergency instrumentation and control (I&C) systems.
- Engineering and procurement of external supplies, including specific equipment, machinery and valves related to the pressurizer.
- The supply of fuel, as well as components and equipment required for fuel operation.
- In addition, other more specific contracts: conventional instrumentation, LTSA (Long Term Support Agreement), ultimate emergency diesel generators, and thermal stress-relief heat treatment.
These projects are carried out for two distinct customers: NNB Generation Company (HPC) Ltd (*) for Hinkley Point C, and Sizewell C Ltd (**) for Sizewell C. This setup illustrates Framatome’s ability to support multiple project owners in the United Kingdom, while leveraging experience gained to deliver reliable and competitive solutions at each site.
(*) NNB is the entity created by EDF Energy, EDF’s UK subsidiary, for the Hinkley Point project, in partnership with the Chinese nuclear group CGNC (China General Nuclear Corporation).
(**) Sizewell C Ltd is the project company established to deliver the SZC project, in which the UK government holds a 45% stake, alongside EDF (12.5%) and other institutional investors.
Key milestones for projects Hinkley Point C and Sizewell C
Hinkley Point C
July 2016
Final Investment Decision (FID) by EDF’s Board
November 2017
Start of Reactor Pressure Vessel manufacturing at Saint-Marcel
December 2022
Completion of manufacturing of Unit 1 reactor pressure vessel at Saint-Marcel
December 2024

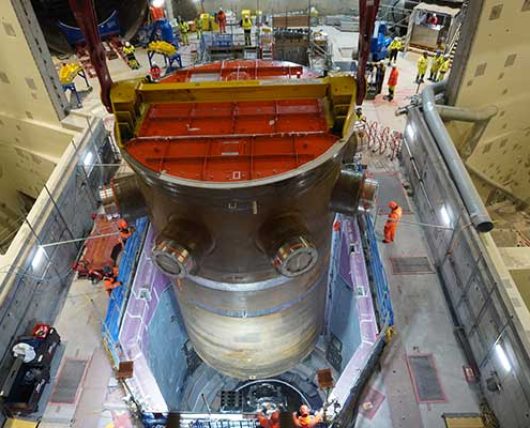

Installation of the reactor pressure vessel in the first reactor building
March 2025
Start of primary circuit welding for Unit 1
October 2025

Installation of the last steam generator in the first reactor building
Sizewell C

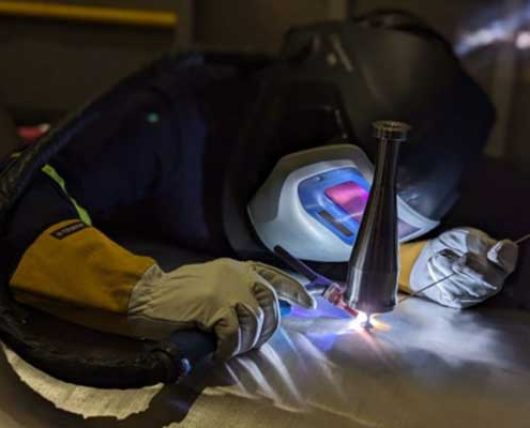

August 2023
Start of manufacturing of the Unit 1 reactor pressure vessel at Saint-Marcel
February 2024
Start of earthworks
April 2024
Signature of contracts between Framatome and Sizewell C Ltd
February 2025
Completion of primary circuit equipment pours at Le Creusot
July 2025
Final investment decision
